Multi-Project Cost Documents

Notice This feature applies to Kahua for Owner, Education, General Contractor and Subcontractors using the Kahua supplied cost applications. If your domain has custom cost extensions or is using Source of Funds, or you are intending to use currencies besides the domain currency, updates are required prior to this functionality being enabled on your Kahua domain.

When enabled, the multi-project cost documents feature allows you to create cost documents in one project, typically at a program (parent) level, that include line items associated with child projects. This allows you to manage a single cost document, such as a contract or a budget, that includes work for multiple projects, while still assigning the cost values to the appropriate project.

This functionality is available for both Expense apps and Funding apps, including Budgets and related documents.

Example

You have a "Campus Improvement" program, and the work done on each building is managed in separate projects, named "Building 1", Building 2", etc.

You set up a program level partition in Kahua, and underneath that program, you set up projects for each building to track the work performed. Each project has budgets, contracts (commitments) and actuals. Each of these may be fully or partially managed from the parent program, using Multi-Project Cost Documents.

You can set up initial budgets for the program and child projects either at the program level OR within each project. You can execute budget changes or budget adjustments from the program, allowing for smooth transfer of budget between child projects and to the parent program.

You have a contract with a company, such as a design firm, that is doing work at the program level and on the individual projects. The designer submits a single pay request each month, but can easily progress work against different building projects within the program.

You can:

  • Create a contract in the "Campus Improvement" partition that includes individual line items for work to be done on the individual Building 1, Building 2, etc. projects.

  • Have the program level contract and each related document such as a change order or pay request move through the approval process as a single record.

  • Enforce Cost Guards (over-committing prevention) at the child project level, even when performing actions at the program level.

  • Receive and approve an individual pay request per pay cycle, submitted against the program level contract, which includes line items for the individual projects.

  • Receive and approve change orders submitted for the contract that include line items for the individual projects.

  • Initiate changes to a multi-project contract either through Issues in the parent project, or with Issues in the child project where one or more contract items are assigned to the child project.

  • View the contribution to the project’s budgets, costs and actuals from the parent project in the project’s work breakdown structure (WBS).

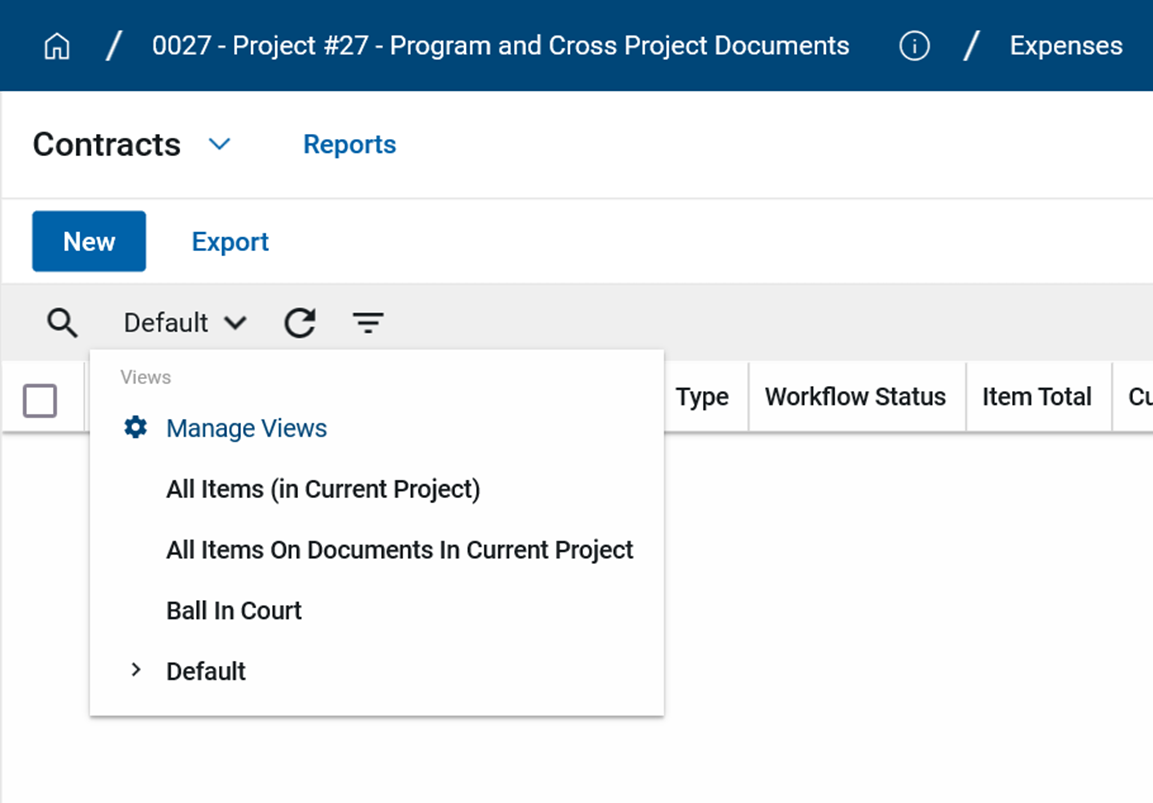

    Note that you can use the All Items view in the Log View manager to view these items in the related document logs.

Important things to know about this feature include the following:

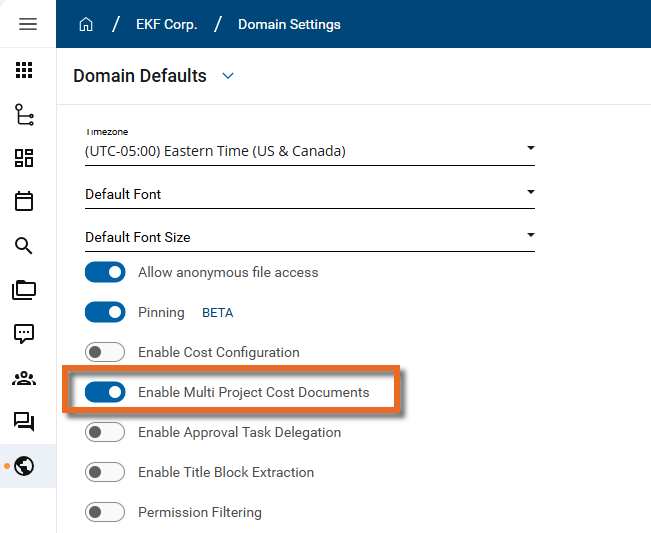

  • Kahua Support must first make the Multi-Project Documents feature available for your domain. Once it is available, the feature must be enabled in your domain, then in the appropriate project, and finally on the documents where you want them to apply.

  • The individual line items are included in the Work Breakdown values for their associated project, and are visible via the drill-through capability.

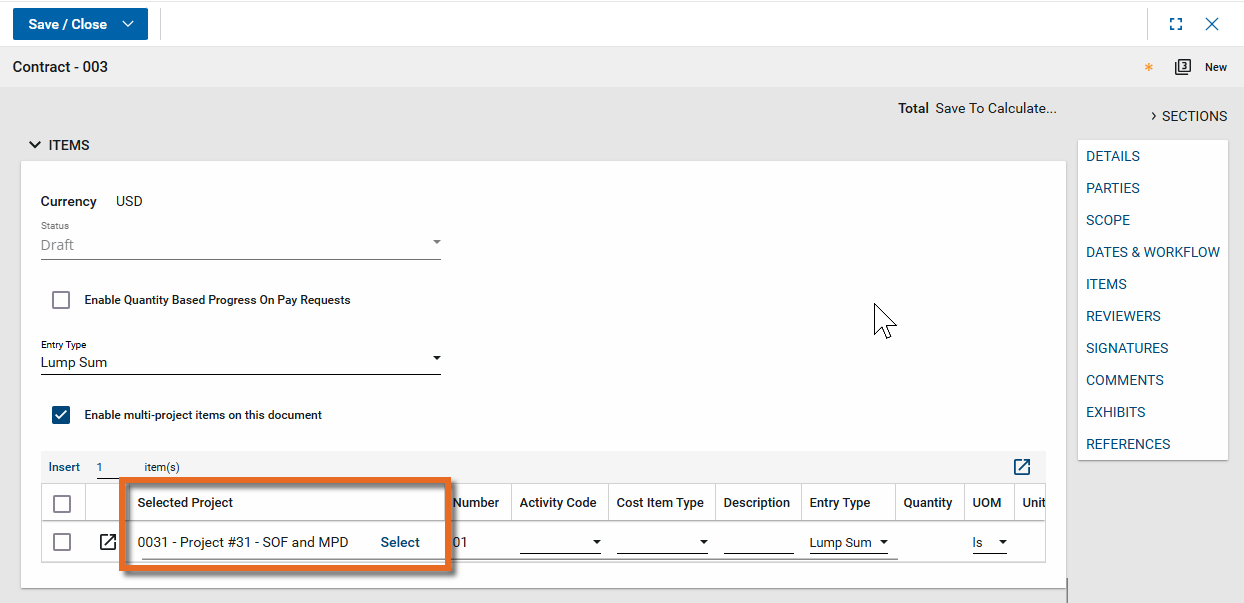

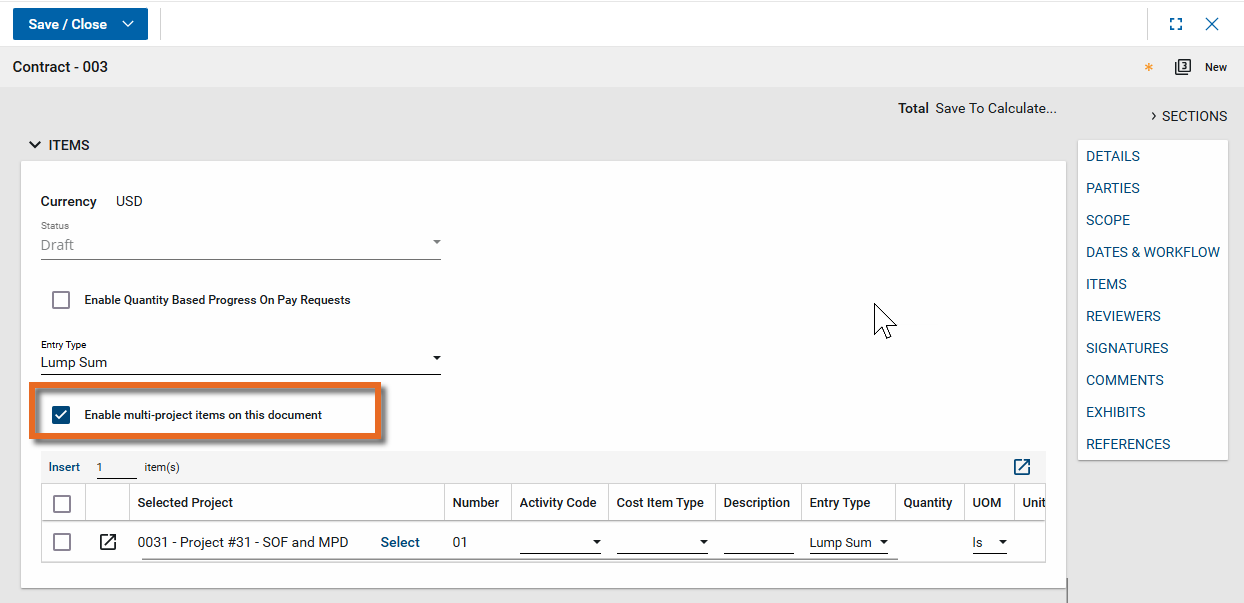

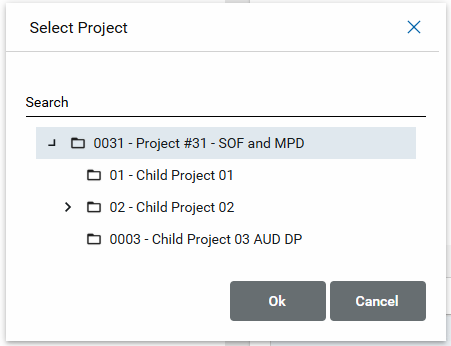

  • When a Contract is set to be multi-project, the associated Change Requests, Change Orders, Schedule of Values Breakdown, and Pay Requests are automatically multi-project documents.

  • When a Purchase Order is set to be multi-project, the associated Purchase Order Change Orders and Invoices are automatically multi-project documents.

  • Budget, Budget Adjustment, and Budget Changes documents function independently, so creating one multi-project document does not require any other document to be multi-project.

  • When you are working with an Issue in a project, you are able to select multi-project documents that reference your current project. In the example above, this would mean that an issue created in the "Building #1" project could include the contract created in the "Campus Improvement" program project.

  • When you are working with an Issue or contract Change Orders in a project and the related contract has Associated Contract Lines enabled, the available contract lines to pick from are filtered by the item’s assigned project.

  • When you are using Cost (over-commitment) Guards, Kahua uses the configuration from the current document’s project to determine the calculations to use, but applies these to the cost item’s activity code in the item’s assigned project. The optimal setup is for the program and child project to use the Cost Guard configuration.

  • When using Process or Save/Copy, the cost item’s assigned project and related project coding are copied over.

  • When using Multi-Currency, the program and child projects must use the same exchange rates and project currency. The optimal setup is for the program and child projects to all share the same multi currency configuration.

  • When using the Data Store for reports or other purposes, the data store respects the cost items assigned project (partition) and the document’s project. Reports leveraging the data store may need to be reviewed and updated, particularly if they assume all the items on a given document are in the same project.

The Multi-Project Documents feature is available for the following applications:

Expenses Funding Other
  • Contracts

  • Change Requests

  • Change Orders

  • SOV Breakdown

  • Pay Requests

  • Purchase Orders

  • Purchase Order Change Orders

  • Invoices (excluding invoices without a related Purchase Order)

  • Budget

  • Budget Adjustment

  • Budget Changes

  • Contracts

  • Change Orders

  • SOV Breakdown

  • Pay Apps

  • Issues

The Multi-Project Documents feature is not available for the following applications:

  • Planning Budget and Planning Adjustment

  • Purchase order invoices without a related purchase order

  • Funding Change Request

  • Sources of Funds (Sources of Funds has a version of cross-project functionality)
